Summary
There is no credible universal oilfield camp cost per bed, per room, or per square meter that can be applied across projects without first defining the project basis. A 300-person camp beside an accessible processing facility, a 300-person drilling camp in a remote desert location, and a 300-person pipeline camp that must relocate as construction advances can have very different installed budgets even if they use similar accommodation modules.
For procurement purposes, the most useful question is therefore not simply, โWhat is the oil and gas camp price?โ It is: What will it cost to deliver an operational camp, at the required location, with the required room standard, climate performance, utilities, installation scope, safety basis, and deployment schedule?
The principal cost drivers are:
- workforce population and occupancy standard;
- percentage of repeatable accommodation modules;
- room specification and private versus shared facilities;
- structural, insulation, HVAC, and environmental design requirements;
- water, wastewater, electrical, and other camp utilities;
- distance from factory or port to the final site;
- transport constraints and shipment configuration;
- civil works and site readiness;
- local installation labor, lifting equipment, and supervision;
- kitchens, dining, laundry, clinics, offices, recreation, storage, and other shared facilities;
- permitting, fire and life-safety requirements, owner specifications, testing, and commissioning;
- whether the camp will be expanded, relocated, or demobilized later.
For a BOFU procurement decision, compare suppliers on landed and operational scope, not on an isolated module price. The lowest ex-factory accommodation price can become the more expensive project option when transport inefficiency, under-specified HVAC, missing utility systems, extensive site assembly, or unclear interface responsibilities are added later.
Why a Single โOil and Gas Camp Priceโ Is Usually Misleading
Buyers understandably want an early number.
A project director might know that 600 workers will mobilize in six months and want a preliminary accommodation allowance. Procurement may ask several suppliers for a โprice per room.โ An EPC estimator may need a number for the temporary facilities section of a tender before the final camp layout exists.
The difficulty is that these numbers describe different things.
One supplier may quote the shell of a modular dormitory. Another includes internal finishes, bathroom fixtures, lighting, air conditioning, furniture, electrical distribution, and plumbing. A third price may include overseas freight but exclude inland transport. A turnkey contractor may include foundations, utility plants, installation, testing, and commissioning.
All four quotations can be technically correct while representing completely different project scopes.
A useful oilfield camp budget therefore needs a defined cost boundary.
A practical equation is:
Total installed camp budget = modular buildings + building fit-out + HVAC + utility infrastructure + shared facilities + freight and import logistics + inland transport + civil/site works + installation + lifting and temporary works + testing and commissioning + compliance requirements + project-specific engineering + spares and agreed contingency items.
If relocation is part of the operating model, add:
relocation budget = dismantling + packing + transport + reinstallation + damaged-part replacement + recommissioning + restoration requirements.
This distinction matters especially for remote energy projects because accommodation is not simply a product purchase. It becomes part of the infrastructure that allows the workforce to operate.
IFC and EBRD guidance on workers’ accommodation treats worker housing as a combination of physical accommodation, sanitation, health, safety, management, and welfare considerations rather than bedrooms alone.
The Eight Cost Drivers That Usually Matter Most
1. Workforce Population, Room Standard, and Occupancy
Headcount is the obvious starting point, but headcount alone does not define accommodation quantity.
Consider a camp planned for 800 people. Before a meaningful pipeline camp cost or oilfield camp cost can be calculated, the supplier still needs to understand:
- how many workers use shared rooms;
- whether supervisors require single rooms;
- whether management accommodation follows a different standard;
- whether bathrooms are ensuite or centralized;
- whether separate accommodation zones are required;
- whether the camp operates at full occupancy continuously;
- whether spare or quarantine rooms are required;
- whether contractor teams are housed within the same compound;
- whether day and night shifts share facilities differently;
- whether the owner has a corporate room standard.
Moving from high-density shared accommodation to lower-density rooms affects far more than bedroom count.
It can increase the number of modules, corridors, doors, windows, air-conditioning units, electrical circuits, plumbing connections, foundations, transport units, installation activities, and ultimately the footprint of the camp.
Ensuite bathrooms add another layer. They require sanitary fixtures, waterproofing, hot-water distribution, drainage, ventilation, wastewater capacity, and additional maintenance access. A shared sanitary block centralizes much of that infrastructure but changes the operating model and accommodation experience.
For this reason, beds are a capacity measure, not a complete pricing specification.
2. How Much of the Camp Can Be Standardized and Repeated?
Repeatability is one of the strongest cost-control mechanisms available in a modular workforce camp.
An accommodation block containing the same room module repeated dozens or hundreds of times provides opportunities to standardize:
- steel frames;
- wall and roof panels;
- doors and windows;
- bathroom assemblies;
- electrical distribution;
- plumbing connections;
- furniture;
- HVAC units;
- replacement parts;
- packaging;
- installation sequence.
The economic benefit does not come only from manufacturing repetition. Standardization also reduces the number of unique drawings, purchasing specifications, packing methods, installation instructions, and spare parts that the project must manage.
Compare two camps with the same number of beds.
Camp A uses one worker-room type, one supervisor-room type, standardized bathroom modules, repeatable accommodation blocks, and a limited number of support-building designs.
Camp B contains many individually customized room layouts, different window sizes, multiple bathroom arrangements, several air-conditioning specifications, and building-specific details.
Camp B may contain the same floor area, but its engineering, procurement, factory control, site coordination, maintenance, and replacement-part burden can be materially higher.
This is why repeatable accommodation blocks are especially valuable when an oilfield development contains several similar operating locations or when a pipeline contractor intends to deploy a standard camp package across multiple construction spreads.
3. Climate, Building Envelope, and HVAC
HVAC can be treated as a minor accessory in a preliminary budget and later become one of the most consequential specification changes.
A remote camp in a hot inland environment does not have the same thermal design basis as accommodation in a temperate coastal region. A cold-climate pipeline project creates another set of requirements. High altitude, dust, humidity, salt exposure, wind, solar load, and large day-to-night temperature variations can also change the engineering basis.
The budget can be affected by:
- wall and roof insulation;
- thermal bridging treatment;
- window specification;
- door sealing;
- vapor and moisture control;
- heating capacity;
- cooling capacity;
- ventilation;
- filtration;
- humidity management;
- HVAC redundancy;
- equipment protection against dust or corrosion;
- low-temperature plumbing protection;
- electrical demand created by HVAC equipment.
ASHRAE’s thermal-comfort standards emphasize that acceptable occupied environments depend on more than a single thermostat temperature; thermal conditions are influenced by several environmental and occupant variables.
For cost planning, the important lesson is straightforward: do not ask a camp supplier to price โair conditioning includedโ without defining the environmental design basis.
A nominal residential air conditioner and a system selected against site-specific summer and winter design conditions are not equivalent specifications.
The supplier should normally receive at least:
- project location;
- elevation where relevant;
- design temperature requirements;
- humidity conditions if material;
- dust or sand exposure;
- corrosion environment;
- required indoor conditions;
- owner HVAC specification;
- expected power source and voltage/frequency;
- any redundancy requirement.
Climate information should be defined before finalizing both the building envelope and mechanical package. Otherwise, a low initial module price can simply move cost into later redesign or field modification.
4. Camp Utilities: The Cost Often Sitting Outside the Bedroom Price
A row of accommodation modules is not yet a functioning workforce camp.
Workers require drinking water, showers, toilets, hot water, lighting, power, drainage, waste handling, food service, laundry, and other daily services. Remote sites may have little or none of the infrastructure needed to provide them.
The utility strategy can therefore alter a remote energy camp budget substantially.
Depending on project scope, utility infrastructure can include:
- electrical generation or connection infrastructure;
- transformers and distribution;
- backup power;
- potable-water storage;
- water treatment;
- distribution pumps;
- hot-water systems;
- wastewater collection;
- sewage treatment or off-site disposal arrangements;
- stormwater systems;
- fire-water infrastructure where required;
- fuel storage and distribution;
- external lighting;
- communications systems;
- solid-waste handling;
- utility control rooms or service modules.
The relevant question is not merely whether these systems are required. Procurement needs to define who supplies each interface.
For example:
Supplier scope: internal room plumbing to a connection point.
EPC scope: underground camp drainage network.
Specialist package: wastewater treatment plant.
Owner scope: raw-water source.
Without an interface matrix, multiple suppliers can all exclude the pipework between their respective systems.
That is how a quotation that appears complete at purchase-order stage produces variation orders during mobilization.
5. Distance, Shipping Configuration, and Last-Mile Logistics
For remote camps, distance affects much more than the freight invoice.
The logistics chain can include:
factory โ export port โ ocean or cross-border transport โ import terminal โ inland staging area โ project access road โ final camp pad.
Different modular systems interact with that chain differently.
A highly compact flat-pack system can improve transport density, although more field assembly is required. A more fully preassembled module shifts more work into the factory but can consume significantly more transport volume. Large volumetric buildings can reduce certain site activities while introducing route, lifting, and dimensional constraints.
The right decision depends on the entire logistics chain.
Questions that should be resolved include:
- Can standard freight equipment reach the project?
- Are there bridge, road, tunnel, or clearance restrictions?
- Are abnormal-load or oversize permits required?
- Is there a dry season or seasonal access window?
- Can the site receive large trucks?
- What cranes or forklifts are available?
- Is intermediate warehousing required?
- Can modules be stacked or packed efficiently?
- Does border clearance create a staging constraint?
- Must delivery be sequenced around camp installation?
U.S. Federal Highway Administration guidance illustrates the principle clearly: oversize or overweight movements can require jurisdiction-specific permits and route controls. The exact transport rules are jurisdictional, so a U.S. threshold should never be copied into another country, but the underlying procurement lesson is universalโroute feasibility must be checked before selecting the transport format.
For a remote oilfield, the expensive part of logistics is sometimes not crossing an ocean. It is the final section from the nearest viable logistics hub to the camp site.

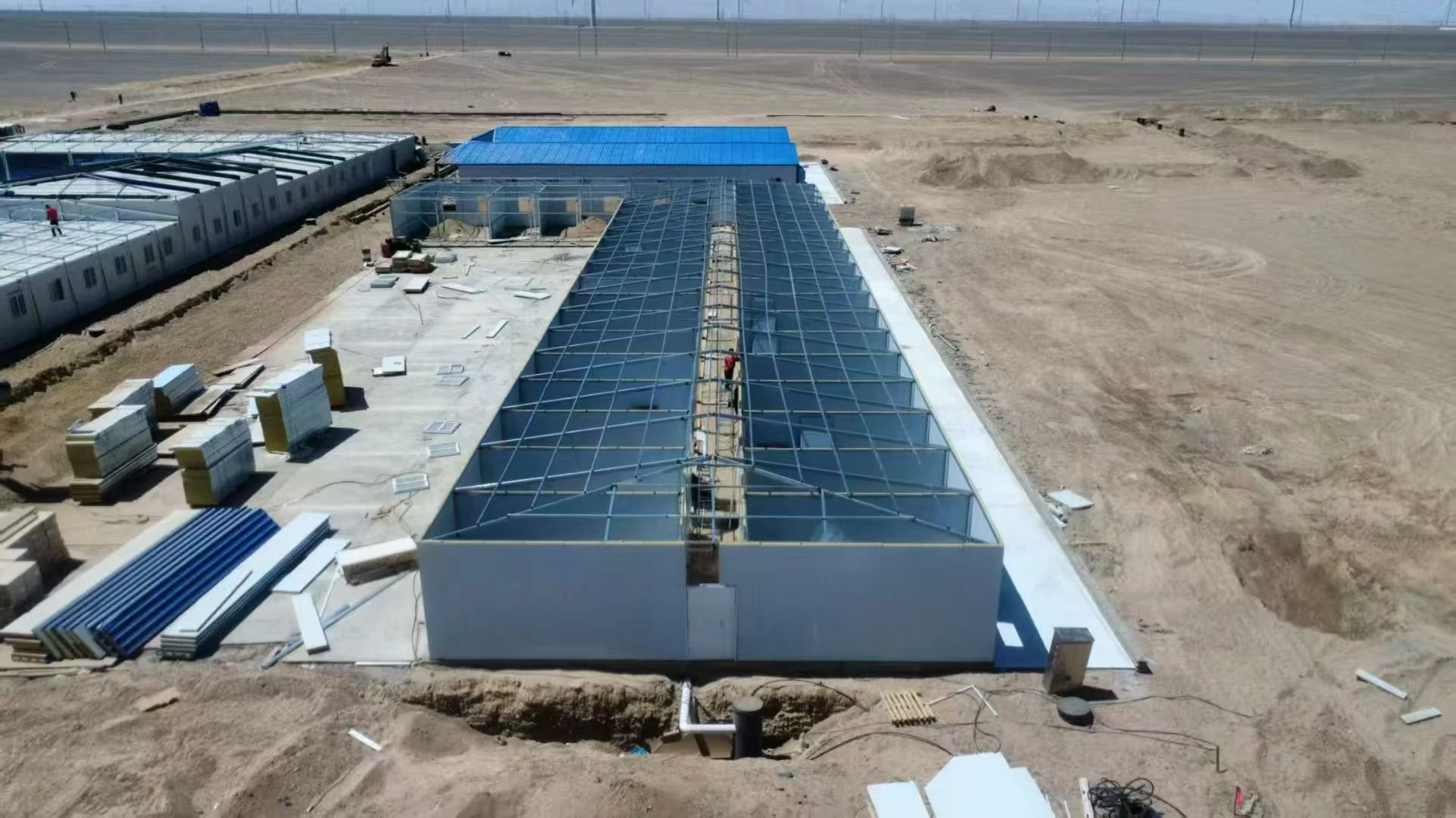

6. Site Readiness and Civil Works
A modular building reduces the amount of conventional construction performed at site. It does not eliminate the site.
The camp still needs suitable ground, drainage, access, foundations or supports, utility corridors, external circulation, and interfaces with other project infrastructure.
Typical site-scope items include:
- clearing and grading;
- geotechnical assessment where required;
- earthworks;
- drainage;
- foundations or support pads;
- access roads;
- crane or installation working areas;
- utility trenches;
- external walkways;
- fencing;
- security gates;
- fire access;
- parking;
- lighting;
- landscaping or erosion control where specified.
Poor ground conditions can change the foundation solution. Flood exposure can change grading and drainage. Difficult topography can increase earthworks. A pipeline camp planned beside a temporary construction spread may intentionally use a lighter site solution than a camp serving a long-term processing plant.
Site selection therefore affects both initial cost and demobilization cost.
This also has a compliance dimension. OSHA’s U.S. temporary labor-camp requirements, where applicable, include provisions concerning drainage, water supply, sanitation, toilets, bathing, laundry, and related camp conditions. Other jurisdictions apply their own regulations and building, fire, health, environmental, and labor requirements.
A procurement team should never assume that a generic camp layout automatically satisfies the destination country’s requirements.
7. Installation Strategy and Local-Labor Dependency
Two suppliers can provide similar modular buildings but require very different site resources to turn them into an operational camp.
One system may arrive largely assembled. Another can offer higher shipping density but require:
- frame assembly;
- panel installation;
- roof work;
- MEP connection;
- bathroom installation;
- sealing;
- finishing;
- testing.
Neither strategy is inherently better.
The correct choice depends on:
- cost and availability of local labor;
- workforce skill;
- immigration restrictions on foreign technicians;
- accommodation required for the installation team itself;
- lifting equipment;
- construction-season length;
- safety rules;
- site access;
- required mobilization date.
A project with inexpensive, reliable construction labor and expensive freight may favor a compact shipping format.
A project with scarce skilled labor, severe weather, and an extremely short installation window can justify greater factory completion even when shipping efficiency is lower.
Procurement should therefore request both factory completion scope and field work scope.
A price comparison that ignores this boundary is incomplete.
8. Compliance, Owner Specifications, and Oil & Gas Interface Risk
Oil and gas projects often operate under more demanding owner specifications than generic temporary buildings.
A project may need requirements covering:
- structural design;
- wind and seismic loading;
- fire detection and alarm;
- emergency lighting;
- egress;
- fire-resistant assemblies;
- electrical standards;
- material certifications;
- earthing and lightning protection;
- sanitation;
- potable water;
- accessibility;
- energy performance;
- occupational health;
- environmental controls;
- inspection documentation;
- quality records.
The accommodation location itself also needs to fit the project’s broader hazard-management strategy.
The World Bank Group’s sector guidance for onshore oil and gas covers not only drilling and production but also pipelines, pump and compressor stations, storage, support operations, and decommissioning. Project-specific health, safety, environmental, and facility-siting requirements therefore need to be coordinated with the wider development rather than decided by the accommodation supplier in isolation.
KUBO’s role in such projects is to translate the approved project basis into a manufacturable modular accommodation package. Process-safety studies, hazardous-area classification, regulatory approvals, and final facility-siting decisions remain with the appropriately qualified project parties and authorities.
That boundary should be clear before quotation.
Oilfield Camp Cost Driver Table: What Procurement Should Define
| Cost driver | Why it changes the budget | Information needed before a reliable quotation | What can go wrong if left undefined |
|---|---|---|---|
| Peak population | Determines accommodation and service capacity | Peak beds, workforce profile, shift model | Camp is undersized or unnecessarily oversized |
| Room occupancy | Changes module quantity and floor area | Beds per room, supervisor/management ratios | Price per bed comparisons become misleading |
| Bathroom standard | Alters plumbing, hot water and wastewater loads | Ensuite, shared or mixed | Utility plant is sized against the wrong demand |
| Standardization | Controls repetition and engineering complexity | Number of room and building types | Excess customization increases procurement and site complexity |
| Climate | Affects envelope and HVAC | Location, temperature, humidity, dust, altitude and corrosion exposure | Poor comfort, high energy demand or redesign |
| Utilities | Can become a major separate package | Available power, water, wastewater and communications | Missing scope appears after contract award |
| Logistics | Determines freight and final-site delivery strategy | Port, road access, route constraints, equipment availability | Modules arrive but cannot economically reach or unload at site |
| Site works | Connects buildings to the physical site | Survey, grading, drainage, soil and foundation basis | Civil cost and schedule expand unexpectedly |
| Installation | Determines field labor and equipment | Local labor, cranes, installation responsibility | Cheap factory pricing becomes expensive field assembly |
| Shared facilities | Scale differently from bedrooms | Kitchen, dining, laundry, clinic, offices, recreation and storage | Initial โcamp priceโ excludes essential operational buildings |
| Compliance | Can alter materials and systems | Destination code, owner standards, fire/life-safety basis | Redesign, approval delay or non-acceptance |
| Relocation | Changes design and lifecycle requirements | Expected moves, transport route and reuse period | Low-cost temporary structures become expensive to move |
The table also shows why early pricing improves sharply once a camp moves from โ500 workers in Country Xโ to a defined basis of design.
Why Pipeline Camp Cost Can Behave Differently from a Fixed Oilfield Camp
Pipeline construction creates a particular budgeting problem: the work front moves.
A fixed camp serving a processing facility or long-term oilfield operations base can justify substantial site infrastructure because the accommodation remains in one location.
A pipeline camp may need a different logic.
Depending on project geography and construction strategy, crews can advance along a corridor, divide into construction spreads, work from multiple temporary bases, or relocate during the program.
This changes the economics in four ways.
Relocation Becomes a Design Requirement
Buildings that will be moved should be evaluated for repeated:
- disassembly;
- handling;
- packing;
- transport;
- reassembly;
- connection and disconnection of services.
A component that is perfectly acceptable for one installation may not be the best choice for repeated relocation.
Connections, wall panels, finishes, plumbing interfaces, lifting points, fasteners, furniture, and spare-parts planning all matter.
Civil Works Need a Different Lifecycle View
A permanent-style foundation can provide a robust base but make little economic sense for a camp that will operate briefly before moving.
Conversely, reducing civil works too aggressively can create drainage, leveling, structural, maintenance, or weather problems.
The appropriate foundation and site solution should reflect intended occupation period, soil conditions, climate, regulatory requirements, and reinstatement obligations.
Logistics Occur More Than Once
A fixed oilfield camp has an initial mobilization and an eventual demobilization.
A relocatable pipeline camp can have several transport events.
The procurement comparison therefore needs to examine cost per deployment cycle, not only initial purchase price.
Standardization Becomes Even More Valuable
When several pipeline spreads use similar accommodation packages, standardizing modules and interfaces can simplify:
- inter-camp transfers;
- replacement parts;
- field repairs;
- crew training;
- inventory;
- layout replication;
- future expansion.
A small saving created by heavy customization during initial procurement can disappear if each camp subsequently requires different parts and relocation procedures.
For a broader planning framework covering site selection, accommodation systems, utilities, and deployment strategy, see KUBO’s guide to planning oil and gas camp housing.
Which Camp Delivery Model Produces the Lowest Total Project Risk?
The cheapest manufacturing approach is not necessarily the lowest-risk project approach. The table below compares three common strategies.
| Decision factor | Standardized flat-pack camp | Higher-factory-completion modular camp | Relocatable/mobile pipeline camp |
|---|---|---|---|
| Typical lifecycle fit | Medium- to long-duration construction or operations camp | Projects prioritizing reduced field finishing | Construction spreads or projects expecting relocation |
| Scalability | High when room and support blocks are standardized | High, although transport volume can constrain expansion logistics | High if deployment packages are standardized |
| Schedule certainty | Good when factory production and field assembly are coordinated | Potentially strong where site labor is constrained | Depends heavily on relocation sequencing |
| Local-labor dependency | Moderate to relatively high | Lower for factory-completed scope | Moderate; repeated handling skills become important |
| Logistics | Good packing density can be advantageous | Greater volumetric freight requirement | Logistics occur repeatedly across the lifecycle |
| Site readiness | Requires prepared installation areas and connections | Still requires foundations and utility interfaces | Site preparation must be repeatable at each location |
| Utilities | Central utility networks work well for large camps | Same requirement unless utility systems are integrated | Temporary, modular or skid-based utility packages can be advantageous |
| Approval | Project-specific | Project-specific | Each deployment location can create additional interface requirements |
| Maintenance | Standardized parts simplify maintenance | High factory integration can reduce field finishing defects | Replaceable parts and connection durability become especially important |
| Relocation | Possible depending on system | Possible, but transport format needs review | Core design objective |
| Interface risk | Can rise if building and site packages are split poorly | Reduced building-completion interfaces but external utilities remain | High unless disconnect/reconnect responsibilities are clearly defined |
| Total project risk | Low when logistics and installation labor are well planned | Low where rapid site completion is the priority | Lowest when mobility has been designed in from the start rather than added later |
This is why a supplier should not recommend the same camp system automatically for every oil and gas project.
The commercial question is not, โWhich module is cheapest?โ
It is, โWhich deployment architecture creates the most controllable total installed and lifecycle cost for this project?โ
Cost per Bed, Cost per Room, or Cost per Square Meter?
All three metrics can be useful. None should be used alone.
Cost per Bed
Cost per bed is useful when comparing alternative accommodation schemes serving the same workforce.
It becomes misleading when one price contains only dormitories while another includes:
- kitchens;
- dining;
- laundry;
- recreation;
- offices;
- clinics;
- utilities;
- external works.
A camp-wide cost per bed should therefore be calculated only after the scope boundary is standardized.
Cost per Room
Cost per room works reasonably well for highly repeatable dormitory procurement.
Its weakness is obvious: a four-person room and a single-occupancy supervisor room are not equivalent products.
Bathroom configuration creates another significant difference.
Cost per Square Meter
Floor-area pricing can help estimators test whether building packages are broadly consistent.
It is weaker for comparing different building functions.
A square meter of open dining space does not have the same MEP and fit-out content as a square meter containing bathrooms, commercial kitchen services, a clinic, or a plant room.
Total Installed Cost
For a final procurement decision, this is the metric that matters most.
A useful normalization is:
Total installed camp cost รท approved camp design capacity = installed cost per design bed.
That result should always be accompanied by a written statement of what is included.
Otherwise, the number has little procurement value.
Why Shared Facilities Can Distort an Early Oilfield Camp Budget
Accommodation modules are repetitive. Support facilities often are not.
This means bedroom pricing can become increasingly accurate while the rest of the camp remains poorly defined.
A complete workforce camp can require some combination of:
- administration offices;
- security and reception;
- medical or first-aid facilities;
- kitchens;
- dining halls;
- food storage;
- cold storage;
- laundries;
- drying rooms;
- changing facilities;
- prayer or quiet rooms;
- recreation;
- gyms;
- training rooms;
- workshops;
- maintenance storage;
- warehouses;
- waste-management areas;
- utility buildings.
Their capacity does not necessarily scale one-for-one with the number of bedrooms.
For example, reducing bedroom occupancy does not automatically double kitchen equipment requirements. Increasing the camp from one workforce phase to another, however, can push a dining facility or wastewater system beyond the capacity around which it was originally designed.
That creates step changes in cost.
This is why large camps should be evaluated as interconnected capacity systems rather than multiplying a single room price by the worker count.
Utilities: Buy for the Initial Phase or the Peak Camp?
This is one of the most consequential BOFU decisions.
Suppose initial mobilization requires 150 beds but peak construction will require 700.
The project can:
- install utility systems sized for the peak from the beginning;
- install modular capacity in phases;
- use temporary services initially and replace them later;
- combine permanent backbone infrastructure with expandable treatment or generation equipment.
Each strategy changes capital timing, schedule risk, and future disruption.
Sizing everything for peak capacity immediately can create unused early-stage capacity.
Sizing only for initial occupancy can create expensive replacement works when later phases arrive.
For phased camps, procurement teams should ask suppliers to identify which assets are:
repeatable โ another identical module can simply be added;
expandable โ the initial system contains planned capacity or connection points;
replaceable โ later growth requires removing the first system and installing a larger one.
These categories expose lifecycle cost more effectively than a single Phase 1 quotation.
Where Low Quotations Commonly Hide Future Cost
Price differences between modular camp proposals should trigger scope analysis before negotiation.
A materially lower quotation can result from legitimate design efficiency. It can also result from missing requirements.
Check for differences in:
Structural Basis
Are wind, seismic, snow, occupancy, stacking, foundation, and local structural requirements based on the same criteria?
Wall and Roof Assembly
Are insulation type, thickness, internal lining, external finish, thermal treatment, and fire performance equivalent?
HVAC
Does each quote use equipment designed for the same site conditions and indoor performance requirement?
Furniture
Are mattresses, wardrobes, desks, chairs, curtains, lockers, and other room items included consistently?
Bathrooms
Are sanitary fixtures, water heaters, exhaust, plumbing connections, waterproofing, and accessories included?
Electrical Scope
Does the building contain only internal wiring, or are distribution boards, external cabling, transformers, generators, and site lighting included?
Plumbing Scope
Where exactly does supplier pipework stop?
Utility Plants
Is water treatment included? Wastewater treatment? Storage? Pumps? Backup systems?
Fire and Life Safety
Which alarms, detectors, emergency lights, extinguishing provisions, signs, doors, and fire-rated assemblies are included?
Freight
Does the quote stop at factory gate, port, destination port, inland logistics hub, or camp site?
Installation
Are local labor, specialist supervision, cranes, forklifts, accommodation for installation personnel, tools, consumables, and temporary facilities included?
Commissioning
Who pressure-tests plumbing, starts HVAC systems, checks electrical circuits, commissions utility plants, and records completion?
This exercise can transform supplier comparison.
Instead of three apparent โcamp prices,โ procurement gets three scope-normalized commercial offers.
The Scope Matrix Is More Important Than the Quotation Total
Before commercial clarification closes, create an interface matrix.
A simplified example:
| Work package | Modular supplier | EPC contractor | Local subcontractor | Owner |
|---|---|---|---|---|
| Building manufacture | Included | โ | โ | Review |
| Furniture | Included | โ | โ | Approve standard |
| Internal MEP | Included | โ | โ | Review |
| Foundations | Design interface | Responsible | Possible execution | Approve |
| External water network | Connection point | Responsible | Possible execution | Source confirmation |
| Wastewater plant | Optional package | Interface | Possible civil works | Discharge criteria |
| Main electrical distribution | Connection point | Responsible | Installation support | Power basis |
| Inland transport | Defined by contract | Coordination | Possible haulage | Access support |
| Crane unloading | Supervision basis | Coordination | Responsible if contracted | โ |
| Module installation | Defined scope | Coordination | Labor if contracted | Inspection |
| Final commissioning | Building systems | Integrated commissioning | Support | Acceptance |
The exact matrix will differ by project.
The principle does not.
Every physical connection should have a commercial owner.
That is one of the most effective ways to prevent remote camp budgets from growing through late interface claims.
How Schedule Pressure Changes the Remote Energy Camp Budget
Camp completion can sit on the critical path of workforce mobilization.
This is especially important when the project cannot simply place arriving workers in nearby hotels.
A shortened schedule can affect:
- factory production sequencing;
- procurement lead times;
- shipment batching;
- use of air freight for critical components;
- number of installation crews;
- crane utilization;
- temporary accommodation;
- phased commissioning;
- utility sequencing.
The lowest manufacturing cost can therefore conflict with the earliest operational date.
A useful tender requirement is to request three schedule dates separately:
- factory-ready date;
- estimated site-arrival basis;
- estimated ready-for-occupancy sequence after site handover.
This prevents โdelivery in X weeksโ from being interpreted as โthe workforce can occupy the camp in X weeks.โ
They are not the same milestone.
Should the Camp Be Bought as One Package or Split Among Suppliers?
A single camp package can reduce interface complexity, but it is not automatically the best commercial solution.
Large EPC projects often split scopes because specialist systems are procured separately.
A modular building supplier might provide:
- accommodation;
- offices;
- sanitary buildings;
- dining structures.
Other vendors might provide:
- commercial kitchen equipment;
- generators;
- water treatment;
- wastewater treatment;
- telecommunications;
- firefighting systems.
This approach can be efficient when the EPC contractor has strong package-management capability.
The risk increases when responsibility for connection points is vague.
A more integrated package can reduce coordination burden but places greater scope with one contractor and requires careful capability verification.
The decision should therefore reflect the project team’s ability to manage interfaces, not only supplier markup.
How to Compare Oilfield and Pipeline Camp Bids Properly
Before selecting a preferred vendor, normalize all quotations against the same basis.
The commercial evaluation should confirm:
- identical peak population;
- identical room schedule;
- identical support-building schedule;
- identical structural and climate basis;
- identical HVAC performance criteria;
- identical furniture scope;
- identical utility boundaries;
- identical fire and life-safety requirements;
- identical freight destination;
- identical import-duty assumptions where relevant;
- identical inland-delivery boundary;
- identical foundation responsibility;
- identical installation responsibility;
- identical commissioning boundary;
- identical spare-parts requirement;
- identical documentation scope;
- identical warranty basis;
- identical planned expansion requirements;
- identical relocation assumptions.
Only after normalization should procurement compare headline totals.
This approach often reveals that two โdifferent pricesโ are simply two different scopes.
When Standardization Can Reduce Lifecycle Cost
A repeatable camp architecture becomes especially attractive when an energy company or EPC contractor expects more than one deployment.
Instead of engineering every camp from zero, the project can establish an approved family of building types:
R1 โ standard worker room
R2 โ supervisor room
S1 โ sanitary module
O1 โ site office
M1 โ medical room
D1 โ dining module or dining block
L1 โ laundry
The project still adapts foundation design, climate package, utility capacity, and local compliance requirements for each location, but the core building families remain consistent.
Benefits can include:
- simpler procurement;
- repetitive factory production;
- easier quality inspection;
- fewer spare-part types;
- easier site training;
- predictable expansion;
- easier transfer of units between projects;
- better documentation control.
For multi-spread pipeline construction, drilling programs, and regional oilfield development, that repeatability can be more commercially important than achieving the lowest price on one individual building.
Lifecycle Cost Matters When the Camp Will Be Used Again
A temporary camp does not necessarily have a short economic life.
Some projects dismantle buildings after construction and redeploy them to another location. Others convert construction accommodation into operating support facilities. Some retain a portion of the camp while selling or removing the remainder.
That changes the investment question.
A procurement team expecting reuse should examine:
- structural durability during transport;
- bolted versus destructive connections;
- panel replaceability;
- protection of finishes during dismantling;
- standardized parts;
- availability of replacement seals and fasteners;
- ease of disconnecting utilities;
- packaging requirements for the second move;
- storage conditions between projects;
- ability to reconfigure room layouts;
- inspection procedure before reinstallation.
A lower initial oilfield camp cost can be economically weaker if the buildings cannot tolerate the intended deployment cycle.
For relocatable assets, ask suppliers to state what parts normally require inspection or replacement during each relocation rather than treating mobility as a marketing label.
What Information Is Needed for a Project-Specific Camp Budget?
A useful supplier enquiry does not need final construction drawings.
It does need enough information to define the project.
For an initial budget, prepare:
Project Basics
- country and project location;
- project type: oilfield, pipeline, gas facility, LNG-related construction, drilling, or other energy infrastructure;
- expected project duration;
- target first occupancy date.
Workforce
- initial population;
- peak population;
- workforce ramp-up schedule;
- worker/supervisor/management split;
- room occupancy requirements.
Facilities
Identify whether the camp requires:
- dormitories;
- management rooms;
- offices;
- reception/security;
- kitchen;
- dining;
- laundry;
- clinic or first aid;
- recreation;
- training rooms;
- storage;
- sanitary buildings;
- maintenance facilities.
Climate and Engineering
Provide:
- temperature conditions;
- wind design criteria if available;
- seismic design basis if applicable;
- snow load if applicable;
- altitude;
- humidity;
- dust or sand exposure;
- corrosion environment;
- applicable building standards;
- owner engineering specifications.
Utilities
State what exists at the site:
- grid or generated electricity;
- raw or potable water;
- sewage connection;
- wastewater treatment;
- communications;
- fuel infrastructure.
Logistics
Provide:
- preferred destination port if importing;
- final project location;
- road-access information;
- dimensional restrictions if known;
- crane or forklift availability;
- customs or local-content requirements.
Commercial Scope
Clarify whether the budget should include:
- ex-factory supply;
- export packing;
- sea freight;
- inland transport;
- installation supervision;
- installation labor;
- cranes;
- foundations;
- utility systems;
- testing and commissioning;
- spare parts.
This information allows a supplier to move from a generic oil and gas camp price toward a project-specific commercial basis.
Get a Project-Specific Camp Budget
If you are comparing an oilfield camp cost, pipeline camp cost, or broader remote energy camp budget, send KUBO the project basis rather than asking only for a price per container.
The most useful starting information is the project location, initial and peak workforce, room occupancy standard, required support facilities, climate conditions, utility availability, required delivery date, expected project duration, and whether relocation or future expansion is planned.
KUBO can then review the accommodation configuration, repeatable camp blocks, modular system, transport strategy, installation scope, and utility interfaces before preparing the commercial basis.
Get a Project-Specific Camp Budget
Frequently Asked Questions
1. How much does an oilfield workforce camp cost?
There is no defensible universal oilfield camp cost because the building purchase price represents only one part of the project. Workforce density, private or shared bathrooms, HVAC, climate design, kitchens and other support buildings, utilities, shipping distance, foundations, installation labor, local regulations, and commissioning scope can all change the installed budget. A useful estimate therefore begins with a room schedule, facility schedule, site location, climate basis, utility strategy, and defined delivery boundary. Suppliers can then quote the same scope and procurement can compare the proposals meaningfully.
2. What is the biggest oilfield camp cost driver?
For many projects, no single driver dominates under every condition. Accommodation population and room standard determine the basic scale, but logistics, utilities, climate specification, and site installation can materially alter the total. A highly standardized large camp close to transport infrastructure can have very different economics from a smaller camp requiring difficult inland transport and standalone water, power, and wastewater systems. Procurement should therefore build a cost-driver register rather than assuming that module quantity alone controls the budget.
3. Why can the pipeline camp cost be higher than expected even when the buildings are temporary?
โTemporaryโ does not mean the camp has no infrastructure requirements. Pipeline camps still require safe accommodation, power, water, sanitation, food service, drainage, site access, installation, and eventual demobilization. If the camp relocates along the pipeline corridor, dismantling, transport, reinstallation, replacement parts, and recommissioning become recurring costs. A mobile camp should therefore be evaluated over its expected number of deployment cycles instead of only its initial purchase price.
4. Is price per bed a good way to compare modular camp suppliers?
It is useful only after the scope has been normalized. Supplier A may calculate a per-bed price from accommodation modules alone, while Supplier B includes dining, laundry, offices, medical rooms, utilities, logistics, and installation. Those values should not be compared directly. Ask each bidder for the total project scope and then calculate installed cost per approved design bed using the same inclusions. Keep the underlying room and facility schedules with the metric so decision-makers understand what the number represents.
5. Does using flat-pack accommodation always reduce camp cost?
Not automatically. Flat-pack systems can improve shipping density and support repeatable large-scale accommodation, which can be advantageous on many remote projects. The tradeoff is that a greater portion of assembly can occur at site. Where local labor, lifting equipment, weather, or installation time is problematic, a more factory-completed solution can be commercially preferable despite less efficient freight utilization. The correct comparison is factory cost plus logistics plus site completionโnot freight density in isolation.
6. How much does HVAC affect an oil and gas camp price?
Its impact depends on the climate and accommodation standard. HVAC cost includes more than the equipment mounted in each room. Extreme temperatures can affect insulation, glazing, door sealing, ventilation, electrical capacity, generators or transformers, controls, and maintenance requirements. Dust, humidity, altitude, or corrosive environments can introduce further specification changes. Suppliers should therefore receive the project climate basis before final equipment selection. A quotation describing only โAC includedโ is not sufficient for a remote energy project.
7. Should generators, water treatment, and sewage treatment be included in the modular camp quotation?
They can be, but the better question is which contractor is responsible for each system and connection. Some EPC projects procure utilities as separate specialist packages. Others prefer a more integrated camp scope. Either model can work. The risk occurs when the building supplier expects the EPC contractor to provide external services while the EPC estimate assumes those services are included with the camp. A written utility interface schedule should identify sources, treatment equipment, storage, distribution, connection points, controls, testing, and commissioning responsibilities.
8. Is a larger standardized camp always cheaper per bed?
Not necessarily, although repetition can improve manufacturing and procurement efficiency. Larger camps can also cross capacity thresholds requiring additional dining space, kitchen equipment, wastewater treatment capacity, electrical distribution, fire protection, medical facilities, roads, or other support infrastructure. Economies created by repeatable dormitories therefore need to be evaluated together with these step changes. The correct engineering question is how each functional system scales as population increases, not simply whether the module count is larger.
9. What should an EPC contractor send to obtain a useful preliminary camp quotation?
Provide the country and project location, initial and peak workforce, worker categories, beds per room, bathroom standard, list of support facilities, climate information, relevant structural criteria, project duration, required occupancy date, available site utilities, proposed import or delivery point, road-access information, and requested commercial scope. A preliminary layout or site plan is useful but not mandatory for the first budget. The more clearly these inputs are defined, the less contingency suppliers need to place around undefined interfaces.
10. How should we compare a Chinese modular camp supplier with a local contractor?
Compare the complete delivered solution rather than labor rates or factory module prices. Evaluate engineering scope, manufacturing quality control, transport format, import logistics, local civil works, installation labor, supervision, utility interfaces, approvals, documentation, commissioning, warranty support, spare parts, and future relocation. A hybrid model is often possible: factory-prefabricated buildings can be combined with local foundations, external utilities, installation labor, and jurisdiction-specific specialist work. The commercial evaluation should identify which party carries each risk before comparing totals.
11. Should a pipeline camp be designed for relocation from the beginning?
Yes, if relocation is genuinely part of the construction strategy. Designing for movement later can be expensive because connections, finishes, utility interfaces, packing systems, lifting arrangements, and spare parts may not have been selected for repeated handling. The procurement specification should define the expected deployment model, including likely number of relocations, transport constraints, site duration, and whether the same modules must be reconfigured at later sites. That allows lifecycle cost to influence the original design.
12. Can KUBO provide an oilfield camp cost before the final layout is complete?
A preliminary budget can be developed before final construction drawings when the key commercial and engineering assumptions are available. The project should at least define location, workforce, occupancy standard, required camp functions, climate basis, utilities, delivery boundary, schedule, and whether future expansion or relocation is expected. KUBO can then develop a reference configuration and identify the assumptions that still require confirmation. The final commercial offer should be updated when the approved room schedule, layout, engineering criteria, and project interfaces are established.
Sources and References
- IFC and EBRD โ Workers’ Accommodation: Processes and Standards โ International good-practice guidance covering planning, construction, living conditions, worker welfare, sanitation, and management of employer-provided accommodation.
- IFC โ Environmental, Health, and Safety Guidelines for Oil, Gas, and Mining โ World Bank Group sector guidance relevant to onshore oil and gas development, pipelines, associated facilities, support operations, and project EHS management.
- U.S. Occupational Safety and Health Administration โ Temporary Labor Camps Standard โ Jurisdiction-specific reference covering camp-site conditions, water, sanitation, toilets, bathing, laundry, and associated requirements where the U.S. standard applies.
- ASHRAE โ Standard 55: Thermal Environmental Conditions for Human Occupancy โ Authoritative HVAC industry reference for evaluating thermal environmental conditions in occupied buildings.
- U.S. Federal Highway Administration โ Oversize and Overweight Load Permits โ Official U.S. reference illustrating how dimensional and weight limits, permits, and route requirements can affect movement of large modular or manufactured building loads.
